preserve townhomes being built

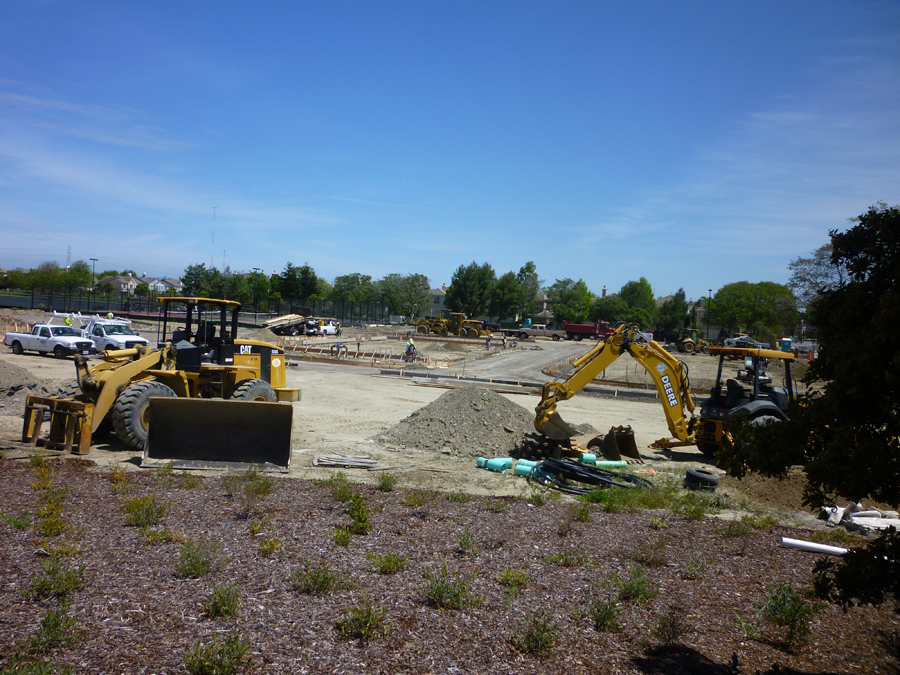

The Preserve
Model Homes
December 2009

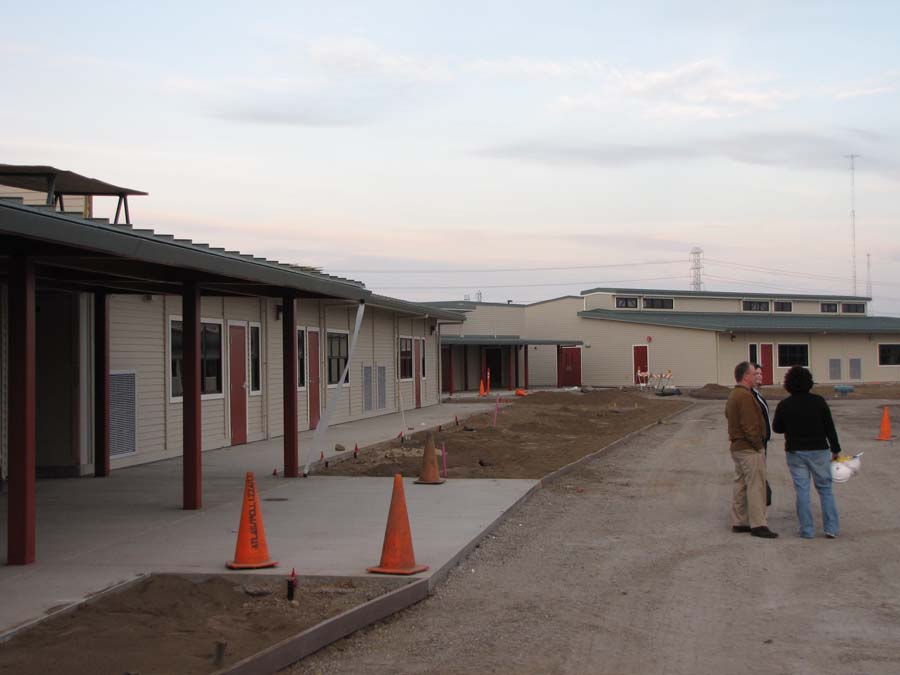

inside the new school

School Progress:
Interiors
December 2009

school exteriors

School Progress:
Exteriors
December 2009

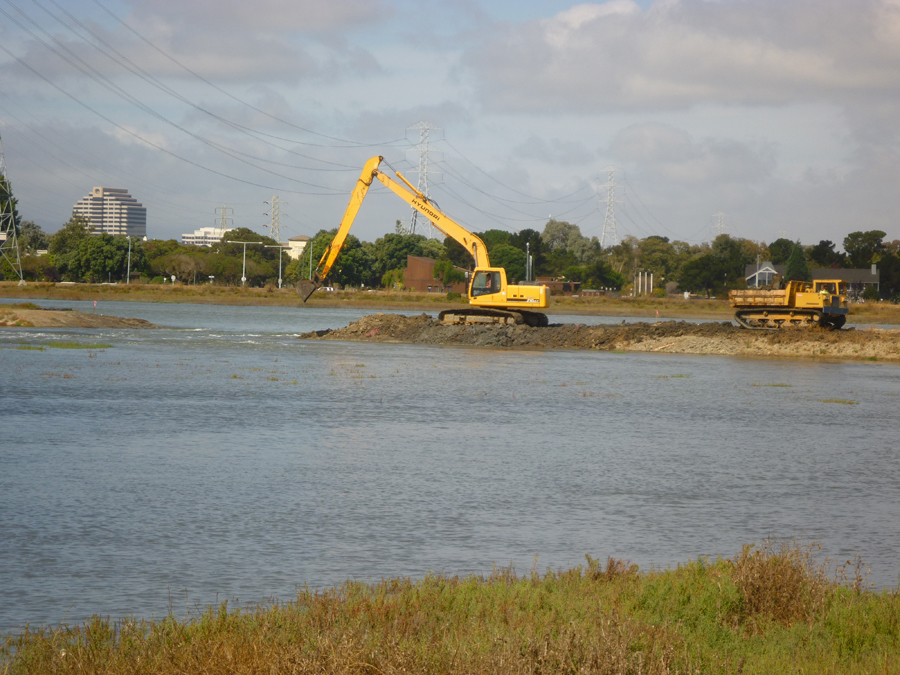

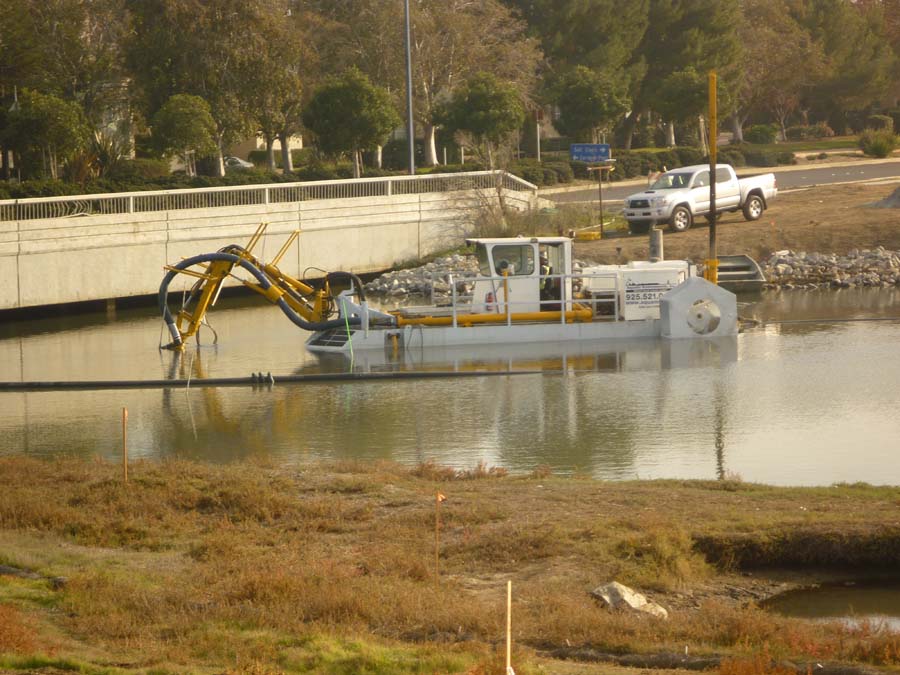

dredging the old lagoon

Dredging the
Old Lagoon
December 2009

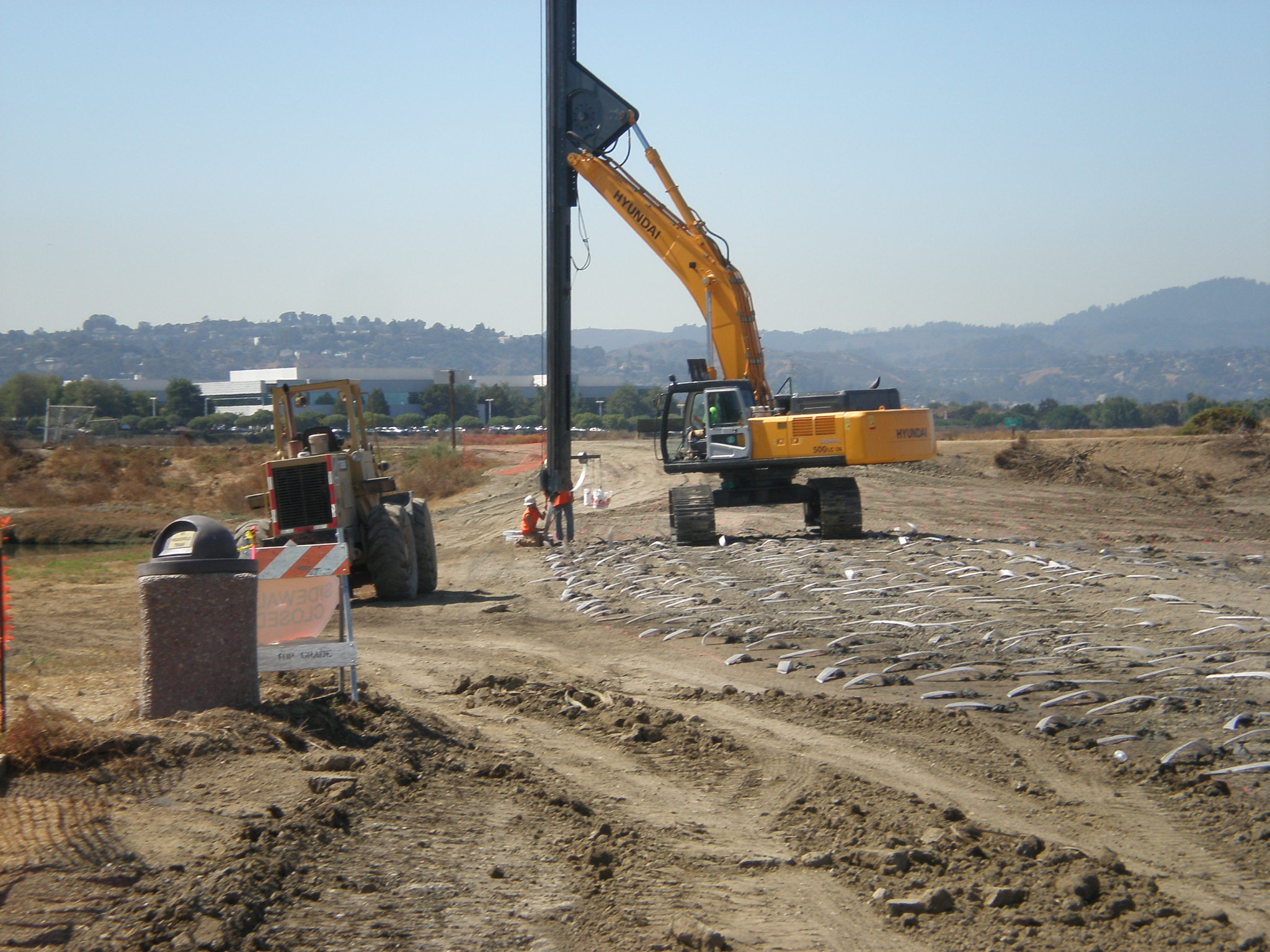

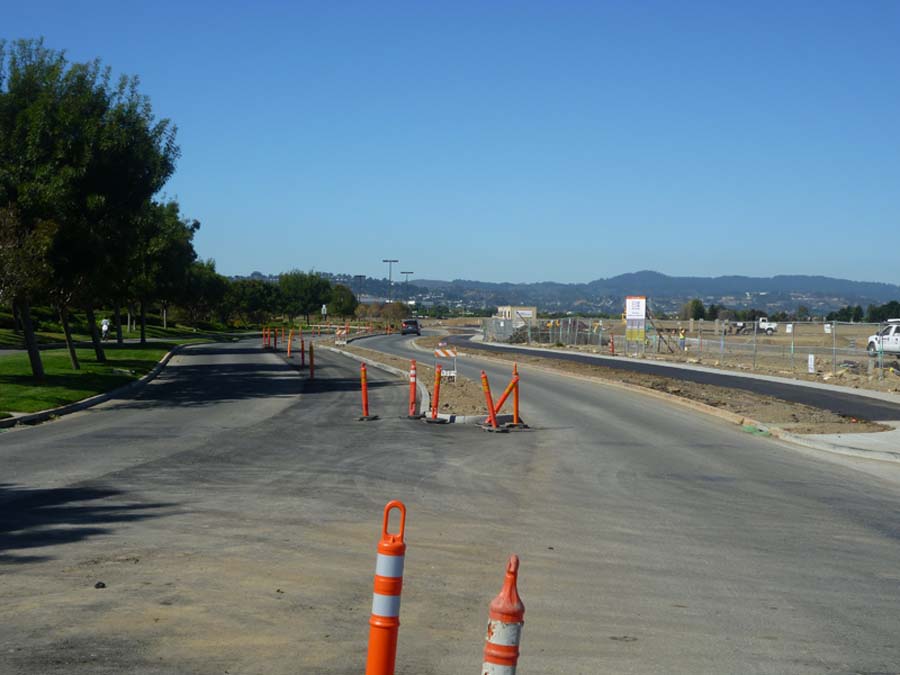

shearwater parkway is widened

Shearwater Parkway
Widens
September 2009

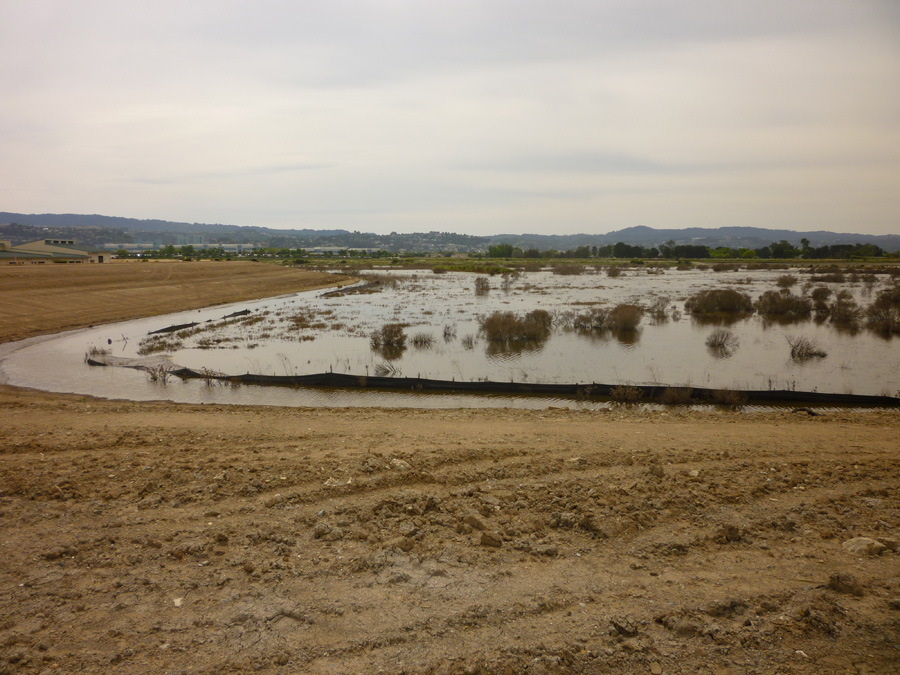

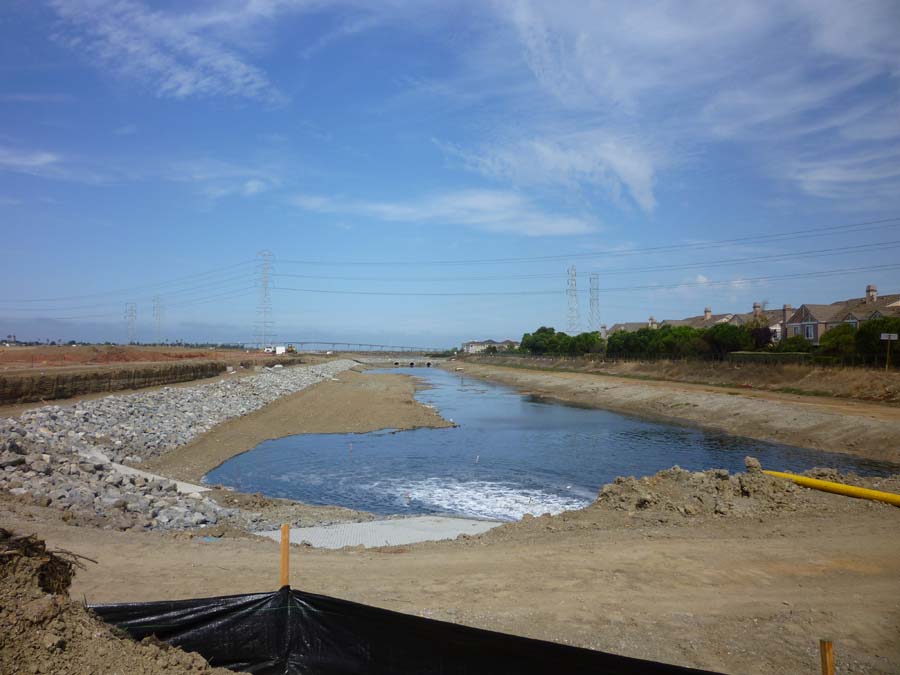

new lagoon

The New Lagoon
September 2009

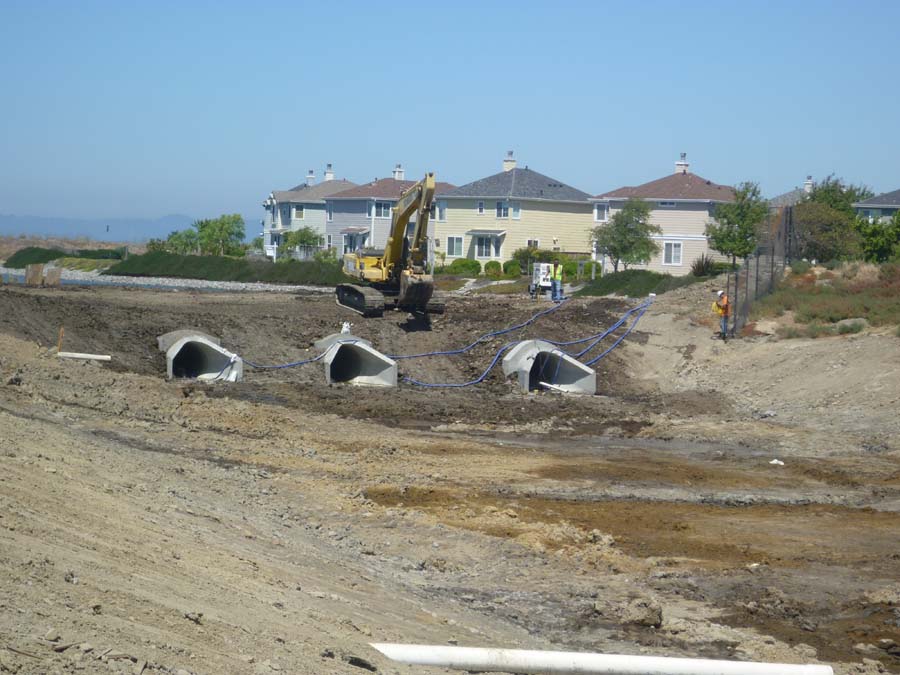

outfalls at old lagoon

Outfalls at the
New Lagoon
August 2009

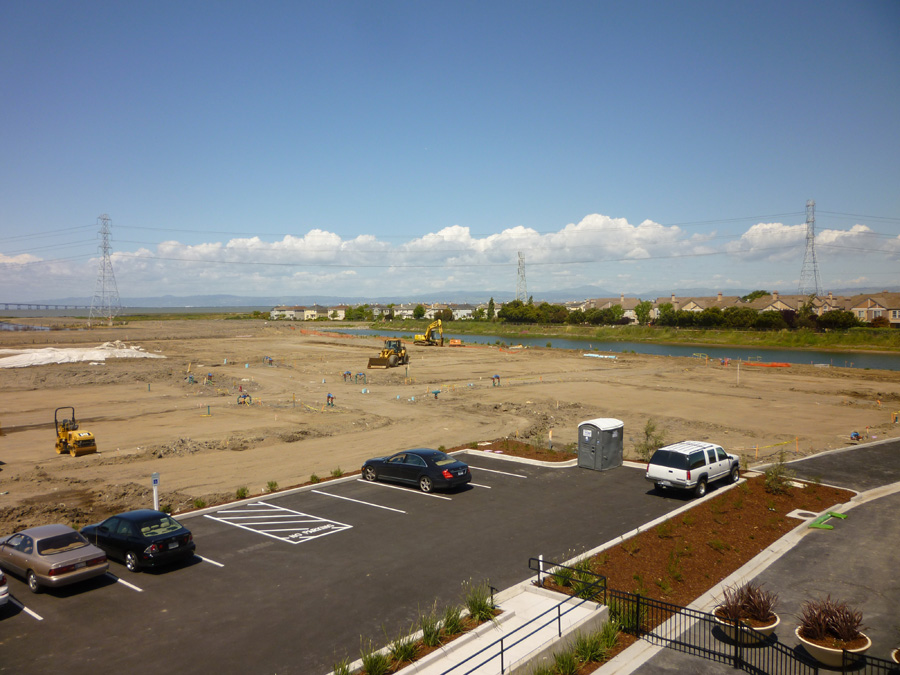

new school groundbreaking

School Groundbreaking
July 2009

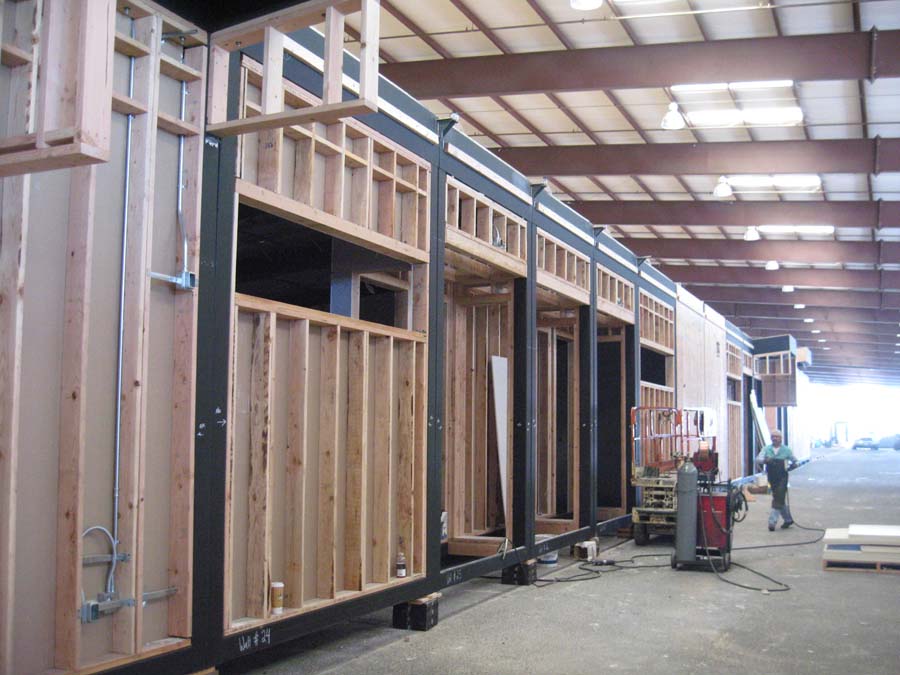

prefabricated school building

School Building
Pre-fabricated
July 2009

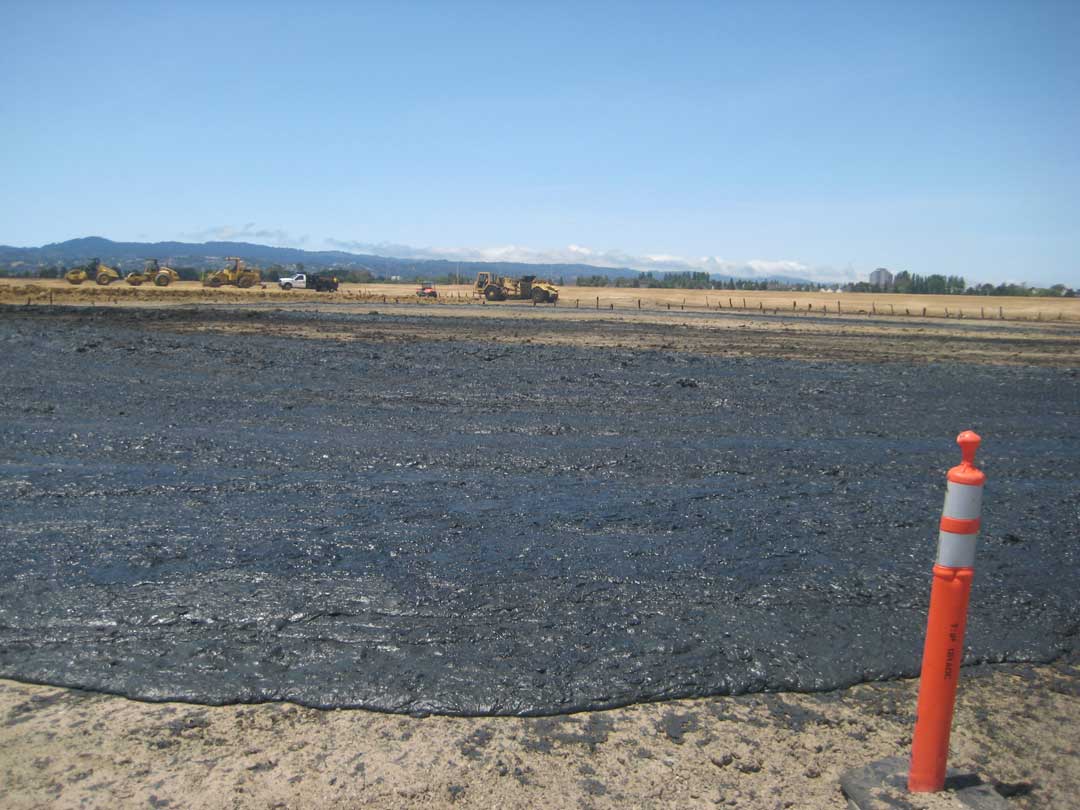

conditioning mud

Conditioning Mud
May 2009

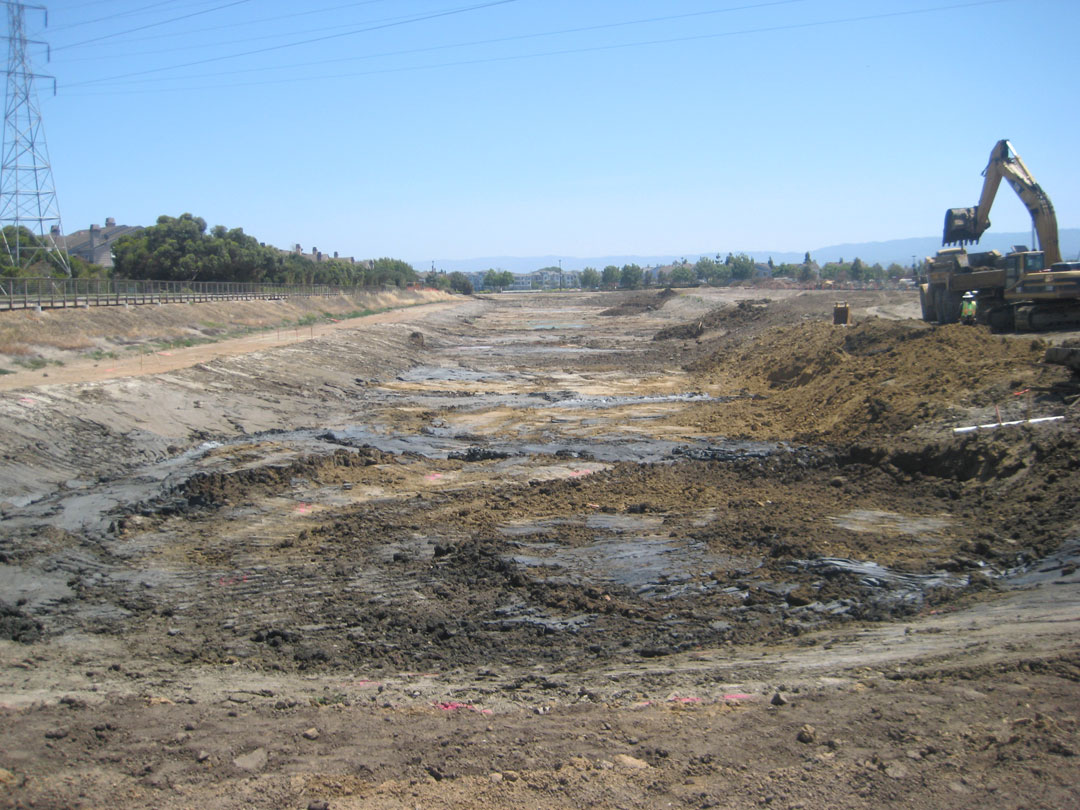

seacrest lagoon

Seacrest Lagoon
May 2009caption
spacer

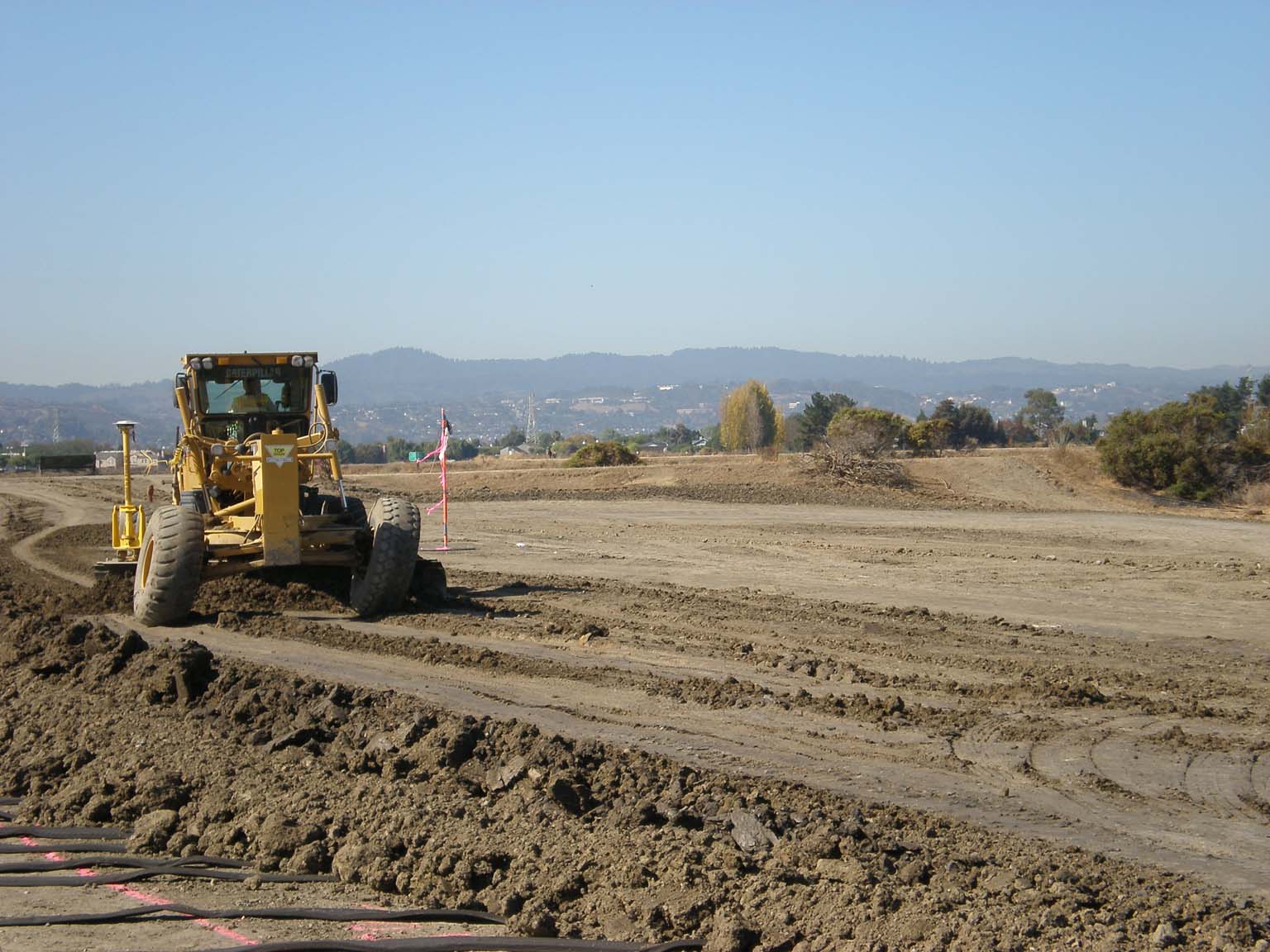

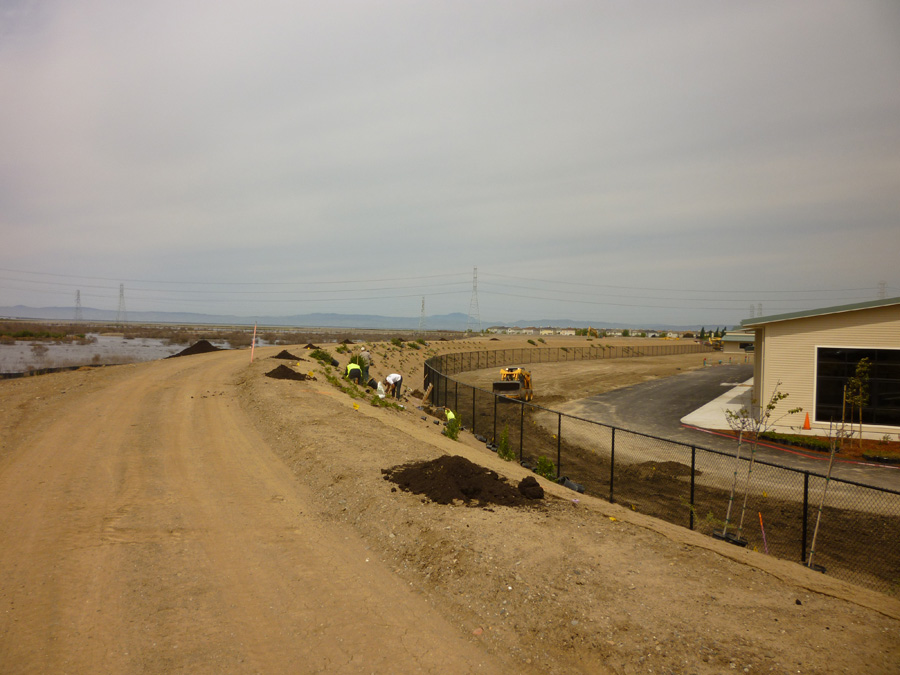

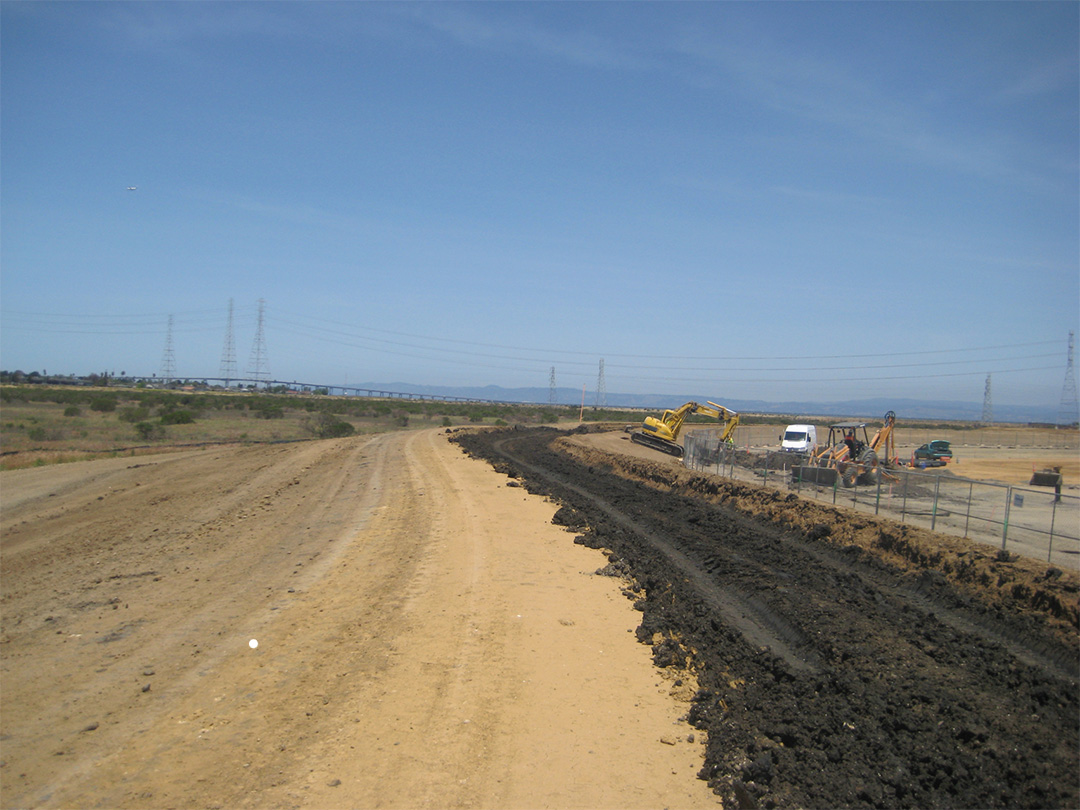

levee built

Levee construction continues
May 2009

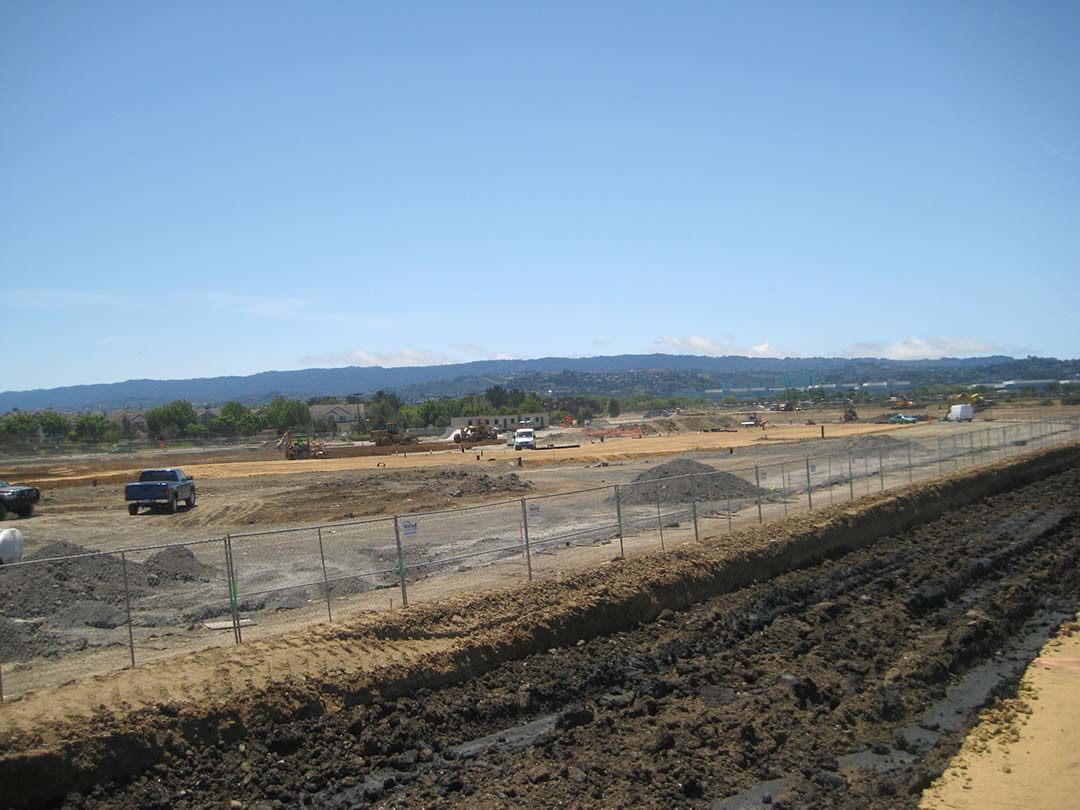

school construction picture

School pad completed
December 2008
spacer

levee_construction

The levee is placed in layers over the wicks
November 2008

"Wick drains" being installed October 2008

Goats clear vegetation
August 2008

spacer spacer

Construction news on The Preserve at Redwood Shores
updated December 15, 2009

Construction of The Preserve is 75% complete and the Fall 2010 opening of Redwood Shores new K-5 elementary school is a virtual certainty. We are also ahead of FEMA’s schedule for completing the new Preserve levee system. Our progress breaks down as follows:

New Shores Elementary School: Keech Properties completed the school pad and turned the site over to the Belmont Redwood Shores School District on December 1st, 30 days ahead of schedule! The District’s contractor, Blach Construction, is now working feverishly on the building interiors and site improvements. Completion is scheduled for early Summer so the Fall 2010 opening should be easily met.

Flood Protection Levee: We completed the basic levee system in August, providing protection to current FEMA standards for all Shores homeowners. As part of the wetlands restoration, a “topping” stage is currently underway. Public access paths, plazas and landscaping will be installed in the spring to complete the system.

Preserve Townhomes: We have broken ground on our new townhomes! Our builder is KB Homes who also constructed the first-rate Seacrest, California Bayside Cove and Shore communities, adjacent to The Preserve. Two, three and four bedroom units ranging from 1,400 to 2,000 square feet will be available beginning Summer of next year. Models will be open by the first of April with floorplans and pricing available in March. Email us to be placed on our "interest list" if you'd like to be the first to obtain more information on design, floor plans, pricing and reservations.

Shearwater Parkway Widening: We have completed most construction on Shearwater Parkway including turn lanes and utilities to the new School site. Expect to see final landscaping installed in the median islands in January.

Wetlands Restoration: Restoration work began in June with excavation of new “slough” channels and construction of “islands” of elevated habitat. We are currently lowering the old exterior levee as we prepare to return full tidal flows to our restoration area in Spring. The 80 acre restored marsh will provide habitat for the endangered California Clapper Rail and Salt Marsh Harvest Mouse. It will also provide wildlife viewing and recreational opportunities from the Preserve’s extensive public trail system.

Site Preparation: Construction began in August 2008 with 900 goats.  They were clearing vegetation in anticipation of Keech Properties, LLC, starting work on this long anticipated project.  By using goats any wildlife in the development areas was able to move out into the restoration areas without harm.

The construction process continued in September 2008 with the installation of vertical "wick drains" below the levee system. These small drains (1/2" x 4") were individually pushed 50 feet below the surface to drain and stabilize the underlying soils (lessons learned from Katrina!). Over 500,000 linial feet of these drains were installed with an individual drain placed every 5 feet! A specific type of "clay" soil was then imported from off-site and used to construst the 12 foot high levee system. In addition, a new lagoon was excavated next to the Seacrest community on Shearwater Parkway.

At completion the Preserve will include a:

  • K-5 Elementary School for 400+ children
  • 3 acre Community Park with parking, picnic areas and tennis courts
  • 156 townhomes
  • 90 acres of restored wetlands, lagoons and hiking trails
  • New exterior levee system built to FEMA standards

Our construction schedule is:

  • November 2009: Begin Townhome construction with first completions expected in Summer 2010
  • January 2010: Landscape the newly-widened Shearwater Parkway
  • December 2009 – May 2010: Complete tidal wetlands restoration, parks and public access improvements
  • April 2009 – July 2010: District to complete school buildings, playground and parking

KB Homes is constructing the new Townhomes. They are a well-respected, national homebuilder.  Work will occur only on weekdays with deliveries coming to the site along Marine Parkway.  KB Homes will ensure that the streets are clean, the site is watered to minimize dust and that hauling (M-F, 7:30 a.m.- 4:00 p.m.) and construction (M – F, 7:00 a.m. – 8:00 p.m.) hours are respected.  If you see any problem that needs to be addressed, we welcome your suggestions.  You may contact KB Homes directly:

Tony Dority
TEL: 510-719-3207
tdority@kbhome.com

Henryk Tay
TEL: 510-719-3534
htay@kbhome.com

You may also contract Keech Properties:

Paul Medeiros, Construction Manager
TEL: 408-529-6020
medeiros4ppjk@sbcglobal.net

We will continue to post updates on the project as our construction process evolves.

Thanks! Due to all your support and hard work “The Preserve at Redwood Shores” has become a reality. We will use our best efforts during the construction process to minimize our impacts on our neighbors and the Shores community.

Our goal is to be a good neighbor and enhance the Redwood Shores community.
